shade 01 What Shade does

Follow the shade.
Stay under the limit.

Shade makes a work plan for a building site in summer heat. The plan moves crews into building shade as the sun moves.

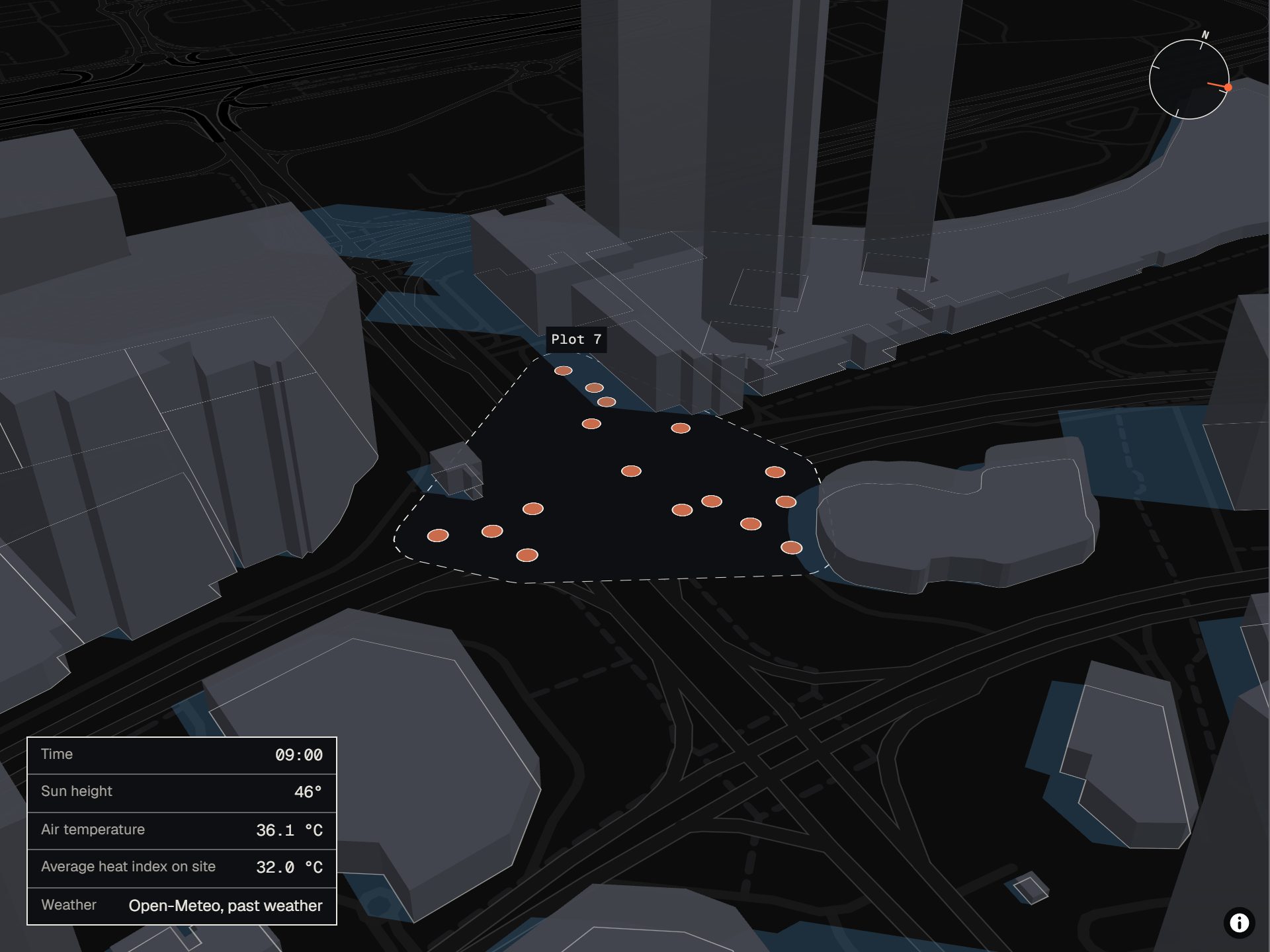

The planner map of Plot 7 in Dubai at 09:00. Building shadows fall across the site, and dots show where the crews work.

02 The problem

The ban stops at 15:00.
The heat keeps going.

In the UAE summer, the law stops outdoor work from 12:30 to 15:00. This rule is the midday ban. Before 12:30 and after 15:00, the heat can still be above a safe limit. A site manager cannot easily see where the shade falls at each hour.

Midday ban, 12:30 to 15:00
05:0008:0011:0014:0017:0020:00

03 What it is

A work plan
that reads the sun.

Shade is a planning tool for building sites in the UAE summer. You give it the site, the workers and the tasks for one day. It gives back a plan for each worker from 05:00 to 20:00, in 15-minute steps.

The plan keeps each worker under a safe heat limit. A heat limit is the most heat a worker can safely take for one type of work. Heavy work has a lower limit than light work. The plan also obeys the midday ban.

04 How it works

Three steps,
every 15 minutes.

  1. 01

    Find the shade

    Shade uses real building outlines and the path of the sun. It finds the shade at each work spot every 15 minutes.

  2. 02

    Set a heat limit

    Shade uses the weather and the shade to find a heat index for each work spot. The heat index (WBGT) adds up air temperature, sun, wind and humidity. Published studies turn the heat index into safe minutes of work per hour.

  3. 03

    Place the crews

    A scheduler puts each crew at a work spot and a time where the work is safe. It also obeys the midday ban.

Fig. 1 How shade moves

Move your pointer across the drawing to move the sun.

05 What we tested

Three plans. One site.
Real weather.

We compared three plans on the same site and the same day. Each day uses real weather from a past summer. We tested two sites, one in Dubai and one in Abu Dhabi. Each site has 14 workers and 12 to 16 building tasks.

  1. 1

    Ban only

    The plan stops work from 12:30 to 15:00. It does not check the heat at other times.

  2. 2

    Heat plan

    The plan keeps each worker under the heat limit. It treats every work spot as if it is in full sun.

  3. 3

    Shade plan

    The plan keeps each worker under the heat limit. It uses the heat at each work spot, in sun or in shade.

For each plan we count the extra hours. Extra hours are overtime after 17:00 plus work that moves to a night shift. One worker-hour is one worker for one hour.

06 Results

The ban is not enough.
A heat plan fixes it.

Extra hours, heat plan
Extra hours, shade plan

Results for each day the planner has run
CityDateMorning weather Over the heat limit, ban onlyExtra hours, heat plan Extra hours, shade planVerdict

Extra hours are overtime after 17:00 plus work that moves to a night shift. All hours are worker-hours. Select a city to open that day in the planner.

07 Who it is for

For the site manager
and the safety officer.

  1. A

    See where work is safe

    The map shows where a crew can safely work at each time of day.

  2. B

    Plan crews around the shade

    The plan moves each crew into the shade as the shade moves across the site.

  3. C

    Give each crew its plan

    You can download the plan as a spreadsheet. It lists the times and work spots for each worker.

08 Sources

Every number
has a source.

Building outlines come from OpenStreetMap. Weather comes from Open-Meteo. The planner lists the full source for each number.
